Hamilton Street Bridge Site

Facility Site ID: 84461527 Cleanup Site ID: 3509

Multi-Family Housing Under Construction

One benefit of redevelopment will be reducing unauthorized access to the site, as evidenced by this hole cut in the security fencing
One benefit of redevelopment will be reducing unauthorized access to the site, as evidenced by this hole cut in the security fencing
We held a public comment period September 28 - October 27, 2020, for a Cleanup Action Plan (CAP) amendmentProspective Purchaser Consent Decree, and Scope of Work and Schedule for a multi-family residential development Sagamore Spokane, LLC is building on a portion of the site.

The CAP amendment explains how the development will enhance the cleanup actions already in place, prevent contaminants from leaving the site during construction, and protect occupants of the new buildings. The Scope of Work and Schedule details engineering, construction, and operations and monitoring reporting requirements, and the schedule for completing these milestones.

Ecology held a public meeting October 14, 2020, (view the presentation), and we responded to two sets of comments. The draft documents were finalized with minor modifications to the CAP amendment to ensure new pilings don't adversely affect groundwater.

Site Background

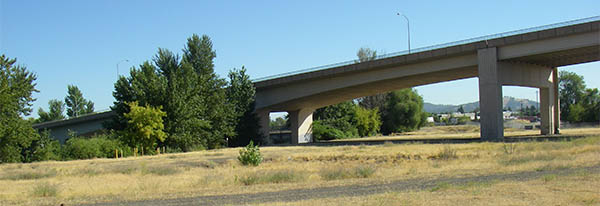

Capped portion of the site, looking northeast
Capped portion of the site, looking northeast
The site is along the Spokane River under the Hamilton Street James E. Keefe Bridge. The site is made up of two adjacent properties, which housed the Spokane Manufactured Gas Plant and American Tar Company. We combined these two properties impacted by the business operations into the Hamilton Street Bridge site.

The Spokane Manufactured Gas Plant produced coal gas and carbureted water gas between approximately 1905 and 1948. The facility was used for mixing, storing, and distributing a propane-air system from 1948 to about 1956. In 1956, the company changed its name to Spokane Natural Gas Company and distributed natural gas from the facility. In 1958, Washington Water Power Company, now Avista Corporation, merged with the Spokane Natural Gas Company. Natural gas continued to be dispensed from the site until about 1963 when Richard Brown leased the property. In 1978, he purchased it, and in 1982 it was deeded to Spokane River Properties, of which he is a general partner.

The parties responsible for cleanup are Avista Corporation, BNSF Railway Company (BNSF), and Spokane River Properties, Limited.

Contamination

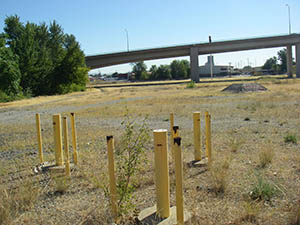

Monitoring wells and capped portion of the site, looking east
Monitoring wells and capped portion of the site, looking east

Contaminants in soil included volatile organic compounds (VOCs) and semivolatile organic compounds (sVOCs), polycyclic aromatic hydrocarbons (PAHs), and metals.

Groundwater samples taken from points surrounding the soil-contaminated area detected relatively few of these materials. Contaminants that were found leaching into the groundwater are undergoing biodegradation and attenuation through physical, chemical, and biological processes.

Investigations show that the Spokane River is not being adversely impacted by the site.

Cleanup

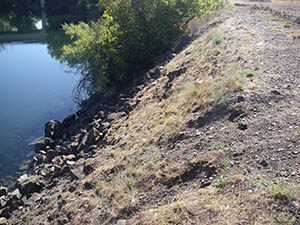

Riverbank stabilization, looking east
Riverbank stabilization, looking east

From 1997 to 2006, the parties responsible for cleanup completed several cleanup actions. A compacted gravel surface serves as a cap that blocks human exposure pathways (ingestion, contact) to contaminated soil.

A restrictive covenant prohibits activities that might result in the release of contaminants. It also ensures the gravel cap and the two building foundations that remain as caps over contamination will be maintained and undisturbed.

Periodic reviews

When restrictive covenants are used, Ecology reviews site information about every five years. We have completed three periodic reviews for this site.

From 2022–2023, we reviewed groundwater monitoring data from 2015–2022 visited the site July 13, 2022, and published the third periodic review. We found Sagamore's construction site fenced and secured. They are following the terms of the Cleanup Action Plan Amendment to prevent exposure to contaminated soil while building the multi-family housing development. We generally found that the cleanup remains effective, but there was evidence of trespassing and people camping along the river. Trees along the riverbank, which were part of the cleanup remedy, had been cut for firewood. We responded to comments from Avista, LimnoTech, and Landau Associates.

Ecology recommended that Sagamore and the parties responsible for cleanup work together to prevent illegal camping and riverbank access and destruction. We added some new groundwater monitoring requirements. When Sagamore's construction is complete, the Operations and Maintenance Manual for protecting the cleanup will be updated to clearly define responsibilities for Sagamore and the parties responsible.

In 2015, Ecology completed the second periodic review and found the cleanup protective of people and the environment. Soil cleanup levels had not been met; however, the cleanup complied with standards, since the cap was in good condition.

Total arsenic and dissolved arsenic were reported above standards during the March 2015 groundwater sampling. Other sampling events around this time showed concentrations of arsenic, mercury, cyanide, and PAHs above standards. We recommended that changes in contaminant levels above state standards, particularly in wells next to the Spokane River, be evaluated to determine if they are impacting the Spokane River.

In 2010, Ecology completed the first periodic review and found the cleanup was still protective of people and the environment. The cap appeared in good condition, with no signs of excavation or other disturbance. No repair, maintenance, or further actions were required.

Site use restrictions called institutional controls are in effect

Institutional controls can be fences, signs, or restrictions on how the property is used. For instance, an institutional control may prohibit installing drinking water wells or disturbing a protective cap that isolates contamination. These restrictions keep the contamination contained and keep people from being exposed to the contamination. The controls are usually listed in environmental covenants recorded with the county.

Periodic reviews are required when institutional controls are required at a site. Ecology conducts reviews to make sure the controls remain effective and the cleanup still protects human health and the environment. We conduct periodic reviews about every five years.

Environmental Covenant

County Recording #: 6839202
County Recording Date: 7/24/2019

Restrictions/Requirements

  • Control Stormwater
  • Ongoing Maintenance of Remedy
  • Prevent the Reuse or Relocation of Site Soil
  • Prohibit New Building Construction
  • Prohibit Soil Disturbance
  • Restrict All Ground Water Extraction/Well Installation
  • Restrict Domestic Ground Water Extraction/Well Installation
  • Restrict Land Use

Restricted Media

  • Groundwater
  • Soil

Environmental Covenant

County Recording #: N/A
County Recording Date: 9/9/2004

Restrictions/Requirements

  • Control Stormwater
  • No on-Site storage of chemicals.
  • Prevent the Reuse or Relocation of Site Soil
  • Prohibit New Building Construction
  • Prohibit Soil Disturbance
  • Restrict All Ground Water Extraction/Well Installation
  • Restrict Domestic Ground Water Extraction/Well Installation
  • Restrict Land Use

Restricted Media

  • Groundwater
  • Soil

Environmental Covenant

County Recording #: N/A
County Recording Date: 1/29/2003

Restrictions/Requirements

  • Control Stormwater
  • No on-Site storage of chemicals
  • Prevent the Reuse or Relocation of Site Soil
  • Prohibit New Building Construction
  • Prohibit Soil Disturbance
  • Restrict All Ground Water Extraction/Well Installation
  • Restrict Domestic Ground Water Extraction/Well Installation
  • Restrict Land Use

Restricted Media

  • Groundwater
  • Soil
Legal 8
Document Title Document Date Document Type
Prospective Purchaser Consent Decree for Sagamore: Hamilton Street Bridge Site 1/5/2021 Consent Decree
Restrictive Covenant for Spokane City Parcel No. 9/5/2019 Environmental Covenant; Alternative Mechanism
Memorandum of Understanding re. City Project Work on the Site 6/14/2016 Interlocal/Interagency Agreement; Memorandum of Agreement or Understanding
Adverse Impact from City Construction Work 5/29/2014 Interlocal/Interagency Agreement; Memorandum of Agreement or Understanding
Restrictive Covenant 9/9/2004 Environmental Covenant; Alternative Mechanism
Hamilton Street Bridge EO Remedial Action 7/13/2004 Enforcement Order
Hamilton Street Bridge - Consent Decree 9/12/2002 Consent Decree
Hamilton Street Bridge AO Remedial Action Avista Corporation BNSF Railway Co. 3/7/2000 Agreed Order
Public Information 8
State Environmental Policy Act 1
Document Title Document Date Document Type
Hamilton Street Bridge SEPA Determination of Non-Significance (DNS) 12/1/2002 SEPA Documents
Technical Reports 82
Document Title Document Date Document Type
Corrective Action, Site Status, Groundwater Monitoring and Sete Security 10/24/2024 Site Specific Administrative Document - other (Administrative correspondence)
Monthly Progress Report No. 38 Sep 2024 10/11/2024 Progress Report
Monthly Progress Report No. 37 Aug 2024 9/16/2024 Progress Report
PPCD Implementation Progress Report No. 36 8/9/2024 Progress Report
PPCD Implementation Progress Report No. 35 7/17/2024 Progress Report
Progress Report No. 34, District on the River Redevelopment May 2024 6/10/2024 Progress Report
Semi-annual (first) 2024 Groundwater monitoring report 5/17/2024 Groundwater Monitoring Report
PPCD Implementation Progress Report No. 33 5/10/2024 Progress Report
PLP (Avista&BNSF) response to final 3rd Periodic REview 5/1/2024 Site Specific Administrative Document - other (Administrative correspondence)
Progress report March 2024 4/10/2024 Progress Report
Prospective Purchaser Consent Decree (PPCD) Schedule Extension Request 4/1/2024 Site Specific Administrative Document - other (Administrative correspondence)
PPCD Implementation Progress Report No. 31 3/11/2024 Progress Report
Ecology Comments on Corrective Action Notice Response dated July 11, 2023 3/5/2024 Site Specific Administrative Document - other (Administrative correspondence)
Corrective Action Notice, Site Security and Soil Stockpiles 2/26/2024 Site Specific Administrative Document - other (Administrative correspondence)
Corrective Action Notice, Site Security 2/26/2024 Site Specific Administrative Document - other (Administrative correspondence)
PPCD Implementation Progress Report No. 30 2/13/2024 Progress Report
Final Third Periodic Review, Recommendations Regarding Groundwater Monitoring 1/25/2024 Site Specific Technical Document - other
PPCD Implementation Progress Report No. 29 1/16/2024 Progress Report
2023 Annual Operation and Maintenance Site Inspection 12/22/2023 Site Specific Technical Document - other
PPCD Implementation Progress Report No. 28 12/10/2023 Progress Report
Progress Report No. 27 for October, 2023 11/17/2023 Progress Report
Third Periodic Review Report 11/2/2023 Periodic Review (5 Year)
PPCD Implementation Progress Report No. 26 10/6/2023 Progress Report
PPCD Implementation Progress Report No. 25 9/8/2023 Progress Report
PPCD Implementation Progress Report No. 24 8/3/2023 Progress Report
PPCD Implementation Progress Report No. 23 7/26/2023 Progress Report
Prospective Purchaser Consent Decree (PPCD) Corrective Action Notice 7/11/2023 Site Specific Administrative Document - other (Administrative correspondence)
Hamilton Street Bridge Site - Prospective Purchaser Consent Decree (PPCD) No. 21200059-32, Corrective Action Notice 7/11/2023 Site Specific Technical Document - other
PPCD Implementation Progress Report No. 22 6/9/2023 Progress Report
PPCD Implementation Progress Report No. 21 6/9/2023 Progress Report
Hamilton Street Bridge Site - Third Periodic Review: Hamilton St. Bridge site 5/19/2023 Periodic Review (5 Year)
Periodic Review 2023, response to Sagamore Spokane LLC comments 5/10/2023 Site Specific Administrative Document - other (Administrative correspondence)
Periodic REview 2023, response to Avista's Comments 5/10/2023 Site Specific Administrative Document - other (Administrative correspondence)
Hamilton Street Bridge - Ecology Response to Comments on the draft Periodic Review Report 5/8/2023 Site Specific Technical Document - other
Progress Report No. 20, District on the River Redevelopment February 2023 4/3/2023 Progress Report
Progress Report No. 19, District on the River Redevelopment February 2023 3/10/2023 Progress Report
PPCD Implementation Progress Report No. 18 1/4/2023 Progress Report
PPCD Implementation Progress Report No. 17 12/6/2022 Progress Report
PPCD Implementation Progress Report No. 16 11/9/2022 Site Specific Administrative Document - other (Administrative correspondence)
PPCD Implementation Progress Report No. 15 9/6/2022 Site Specific Administrative Document - other (Administrative correspondence)
PPCD Implementation Progress Report No. 14 8/16/2022 Site Specific Administrative Document - other (Administrative correspondence)
PPCD Implementation Progress Report No. 13 7/12/2022 Site Specific Administrative Document - other (Administrative correspondence)
PPCD Implementation Progress Report No. 12 6/6/2022 Site Specific Administrative Document - other (Administrative correspondence)
PPCD Implementation Progress Report No. 11 5/5/2022 Site Specific Administrative Document - other (Administrative correspondence)
Engineering Design Report: Hamilton Street Bridge/Sagamore development 4/26/2022 Engineering Design Report
PPCD Implementation Progress Report No. 10 4/15/2022 Site Specific Administrative Document - other (Administrative correspondence)
Engineering Design Report 3/22/2022 Engineering Design Report
PPCD Implementation Progress Report No. 9 3/8/2022 Site Specific Administrative Document - other (Administrative correspondence)
PPCD Corrective Action Notice 1/23/2022 Site Specific Administrative Document - other (Administrative correspondence)
PPCD Implementation Progress Report No. 8 1/17/2022 Site Specific Administrative Document - other (Administrative correspondence)
PPCD Implementation Progress Report No. 7 11/15/2021 Site Specific Administrative Document - other (Administrative correspondence)
PPCD Implementation Progress Report No. 6 9/15/2021 Site Specific Administrative Document - other (Administrative correspondence)
PPCD Implementation Progress Report No. 5 8/25/2021 Site Specific Administrative Document - other (Administrative correspondence)
PPCD Implementation Progress Report No. 4 7/15/2021 Site Specific Administrative Document - other (Administrative correspondence)
PPCD Implementation Progress Report No. 3 6/10/2021 Site Specific Administrative Document - other (Administrative correspondence)
Final EDR Approval Letter 6/1/2021 Site Specific Administrative Document - other (Administrative correspondence)
Approval of Cleanup Action Implementation, Addendum 1, Engineering design Report 6/1/2021 Site Specific Administrative Document - other (Administrative correspondence)
PPCD Implementation Progress Report No. 2 4/30/2021 Site Specific Administrative Document - other (Administrative correspondence)
Final Engineering Report 4/29/2021 Engineering Design Report
PPCD Implementation Progress Report No. 1 4/6/2021 Site Specific Administrative Document - other (Administrative correspondence)
Scope of Work and Schedule: Hamilton St. Bridge CAP Amendment 1/5/2021 Scope Of Work
Cleanup Action Plan Amendment: Sagamore Development Hamilton Street Bridge Site 1/5/2021 Cleanup Action Plan
Sagamore PPCD Soil and Soil Gas Investigation Report 6/22/2020 Site Specific Technical Document - other
2nd semi-annual groundwater report, 2019 12/10/2019 Groundwater Monitoring Report
2019 Annual Site Inspection Report 11/22/2019 Site Specific Technical Document - other
Request to enter into a Prospective Purchaser Consent decree 8/15/2019 Site Specific Administrative Document - other (Administrative correspondence)
1st Semi-annual Compliance Groundwater Monitoring Rpt. 2019 6/5/2019 Groundwater Monitoring Report
2018 Annual Operations & Maintenance Site Inspection: Hamilton Street Bridge 1/3/2019 Performance/Confirmational Monitoring Plan or Report
Groundwater Compliance Sampling: Chlorine and Sulfide Screening 6/26/2018 Site Specific Technical Document - other
Letter to the City of Spokane: MLK Jr. Phase 2B Stormwater plan 2/12/2018 Site Specific Administrative Document - other (Administrative correspondence)
Semi-annual GW Monitoring Report 2nd Event 2017 12/19/2017 Groundwater Monitoring Report
Change of Ecology Site Coordinator 9/14/2017 Site Specific Administrative Document - other (Administrative correspondence)
Semi-annual GW Monitoring Report, 1st Event 2017 7/31/2017 Groundwater Monitoring Report
Second Periodic Review: Hamilton Street Bridge 12/3/2015 Periodic Review (5 Year)
Periodic Review: Hamilton Street Bridge 8/27/2010 Periodic Review (5 Year)
Cleanup Action Completion Report 2/2/2006 Final Cleanup Action Report
Operation and Maintenance Plan 1/8/2004 Operation and Maintenance Plan
Engineering Design Report 9/28/2003 Engineering Design Report
Institutional Control Plan 5/29/2003 Site Specific Administrative Document - other (Administrative correspondence)
Compliance Monitoring Plan 5/28/2003 Performance/Confirmational Monitoring Plan or Report
Final Cleanup Action Plan 8/10/2001 Cleanup Action Plan
HAMILTON STREET BRIDGE SITE Site Hazard Assessment 8/1/1998 Site Hazard Assessment Report
There may be more documents related to this site. To obtain documents not available electronically, you will need to make a public records request.

Places to see print documents

  • Eastern Regional Office
    N 4601 Monroe St
    Spokane, 99205-1265
    Please schedule an appointment to view print documents at this location.

Contaminants 2

Contaminant Type
Soil
Groundwater
Surface Water
Air
Sediment
Bedrock
Non-Halogenated Organics - Polycyclic Aromatic Hydrocarbons RA RA
Metals - Arsenic C
S
Suspected
C
Confirmed Above Cleanup Levels
B
Below Cleanup Levels
RA
Remediated-Above
RB
Remediated-Below
R
Remediated
This contaminant list was based on our best information at the time it was entered. It may not reflect current conditions at the site.
